You're standing in a parking lot with a promising tenant demand story, a shortlist of charger vendors, and one hard question nobody wants to answer first, can the site support the load without turning the project into a utility delay?
That question decides whether commercial EV charging station installation becomes a smooth capital project or a long, frustrating exercise in redesigns, rework, and waiting on approvals. I've seen plenty of Southern California properties get stuck because someone picked hardware before they checked service capacity, utility timing, and accessible stall layout. The properties that move fastest treat the electrical and utility side as the primary project, then choose charger hardware around it.
Evaluating Your Property for EV Charging Infrastructure

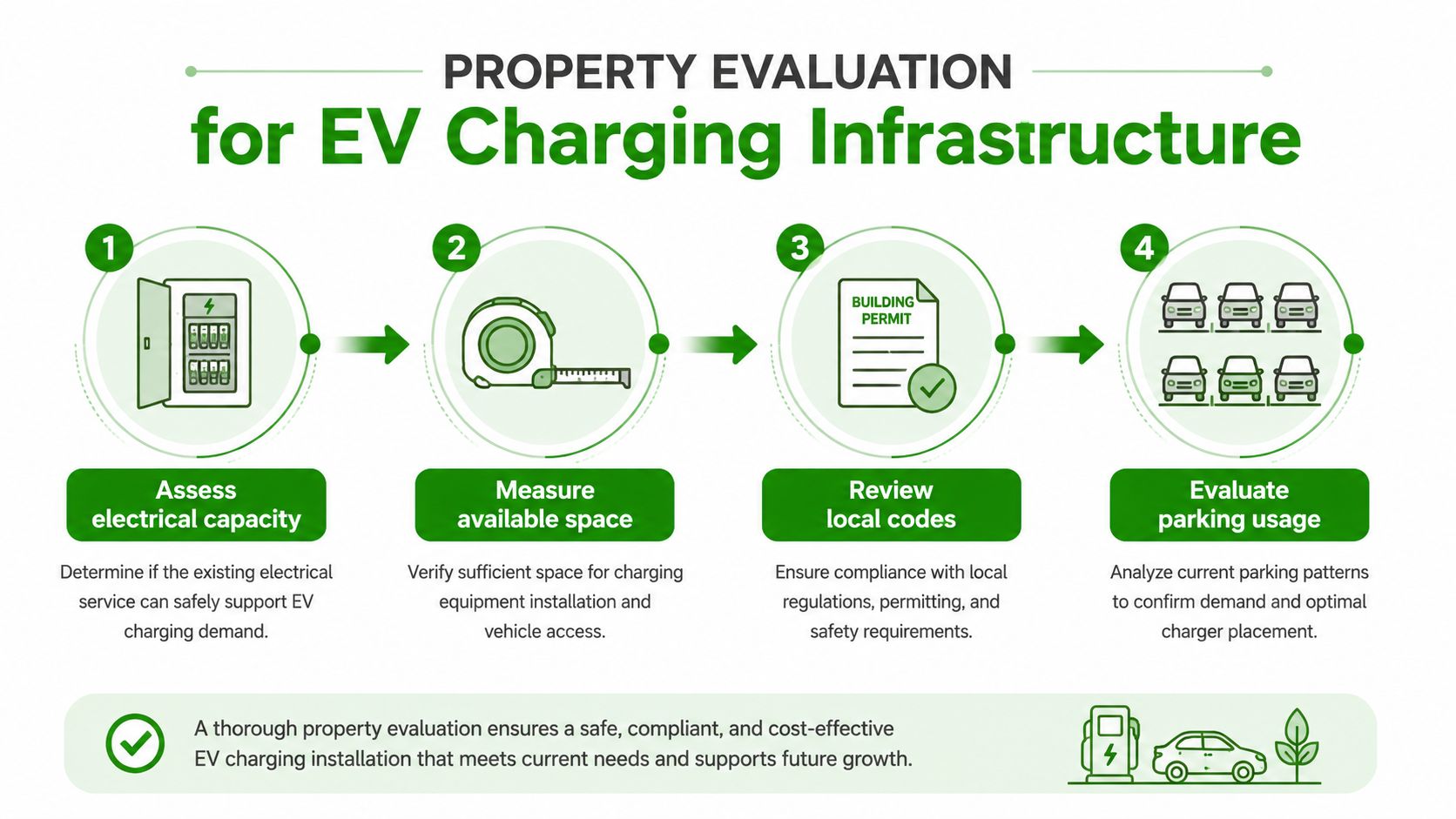

A site review starts with the electrical service, not the charger brochure. The first thing I check is whether the existing service, switchgear, and distribution gear can carry the added load without forcing an upgrade that should have been identified on day one. For commercial EV charging station installation, the utility conversation belongs at the front of the project, not after equipment is selected. I also look at whether the site has reliable connectivity for networked chargers and whether the electrical upgrade budget is realistic before anyone commits to the location.

Start with the electrical reality
I tell property managers to treat the panel as the starting point, not the finish line. If the available capacity is tight, the project may still work with load management or a phased deployment, but that decision has to happen before the permit set is drawn. Once the equipment is ordered, you have already lost time and flexibility.
Practical rule: If the utility and electrical contractor cannot explain how the site will be energized, the project is not ready for procurement.
In Orange County, the jobs that stall usually do so because the site looked simple on paper and became more complicated once the feeder, transformer, or service gear was reviewed in the field. That is why I insist on a site walk with the panel schedule, utility service data, and a realistic plan for future expansion, not just the current charger count. You want a property that can handle today's demand and tomorrow's additions without ripping out half the parking lot.
Measure the parking layout like a contractor
Parking geometry matters because charger placement affects conduit length, trenching, and traffic flow. Measure stall widths, accessible routes, and how many spaces can be dedicated without creating circulation problems for tenants or guests. If the chargers are too far from the electrical room, civil cost rises fast, so proximity to the electrical infrastructure should carry real weight in the layout decision.
Accessibility cannot be an afterthought. The U.S. Access Board recommends an accessible charging space of at least 11 feet by 20 feet with a 5-foot access aisle, the shortest accessible route to the building entrance, and 98 inches of vertical clearance in garages, and those details should be checked against the actual site, not guessed U.S. Access Board guidance. For multifamily and retail properties, that can change where the first chargers belong.
A useful internal reference for planning the parking-side work is our EV charger installation planning guide, especially if you are comparing charger placement options against the available electrical infrastructure.
Choosing Between Level 2 and DC Fast Charging

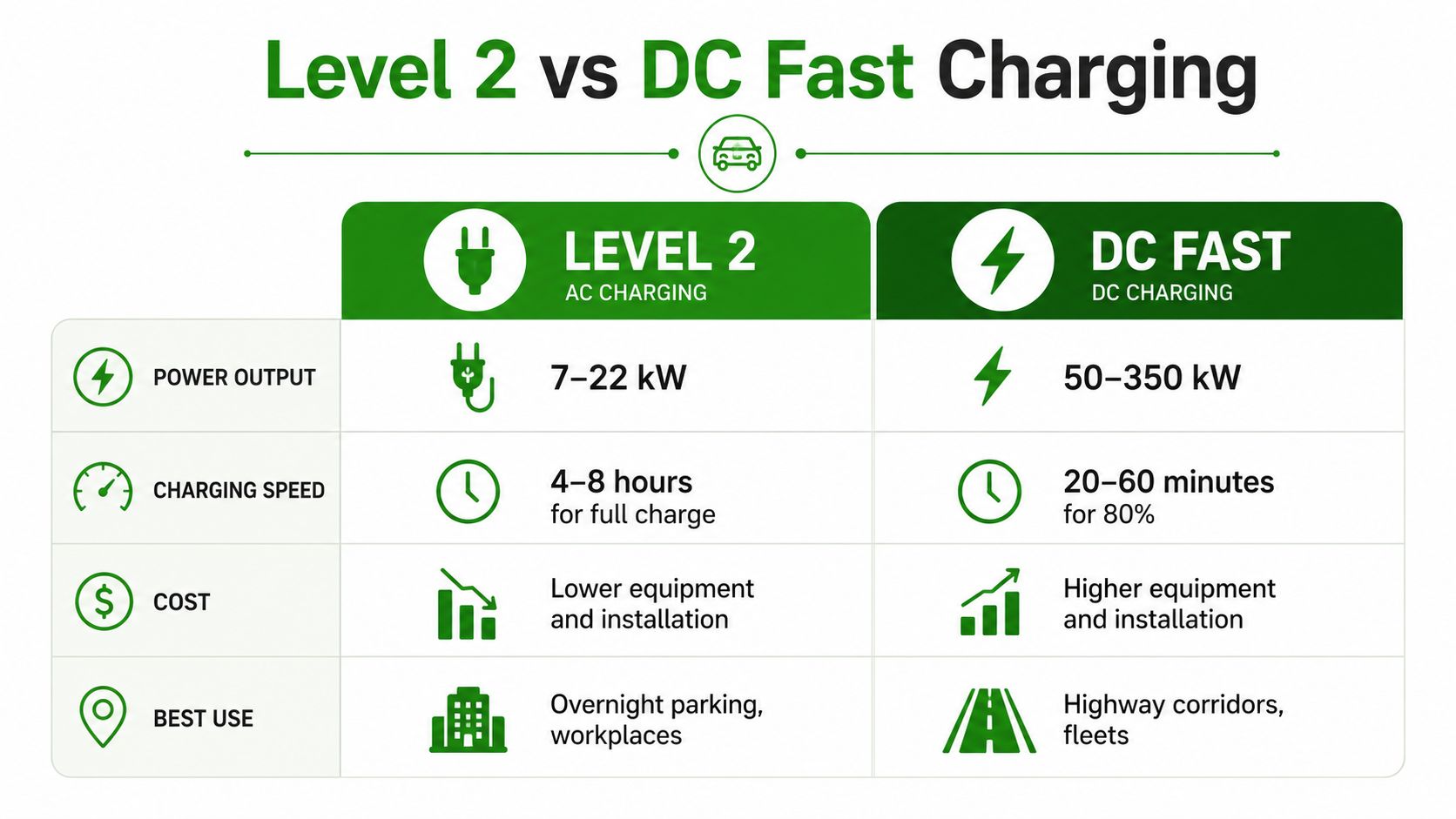

The wrong charger choice creates expensive disappointment. Level 2 AC chargers and DC fast chargers solve different problems, and the decision should follow how long vehicles stay on site, not what looks impressive in a proposal. For offices, multifamily buildings, and retail centers where cars park for long periods, Level 2 usually fits the use pattern. For highway-adjacent sites, fleets, and locations built around short dwell times, DC fast charging may be the better operational fit.

Match charger speed to parking behavior
Level 2 equipment works when the vehicle stays parked long enough to benefit from slower, steadier energy delivery. That's why it fits workplaces, tenant garages, and destination retail where drivers are already on site for hours. DC fast charging belongs where turnover matters, where a site can support the electrical demand, and where drivers expect to leave with a major charge boost in a short stop.
The installation trade-off is simple. Level 2 usually needs less infrastructure work, while DC fast charging pulls harder on the site's electrical system and often demands more complicated coordination. If the property doesn't have the service capacity or the electrical room layout to support high-power equipment, forcing DC fast charging onto the site can create a cost structure that never makes sense operationally.
Think about what the charger needs to do
Networked features matter in both cases. Payment processing, remote monitoring, user access control, and load management can all be useful on a commercial property, especially if multiple tenants or visitor groups share the same equipment. Building management integration also matters when the owner wants visibility into usage and maintenance, not just a row of live ports.
A charger that fits the parking pattern but can't be monitored or managed usually creates more work for staff, not less.
The conversation gets practical. If the property needs long-dwell charging for residents or employees, Level 2 often gives the owner more flexibility and a lower barrier to deployment. If the site is built around throughput and the utility can support the load, DC fast charging can serve a very different business model, but it has to be justified by actual use, not optimism.
Navigating Permits, Utilities, and Incentive Programs
Permits and utility coordination are where a lot of commercial EV charging station installation projects slow down. The drawings can look finished, but the utility still has to review interconnection, confirm the impact on available capacity, and decide what work belongs on its side of the meter. In California, that is often the schedule driver, not the permit counter.
I handle the process in that order. The electrical contractor prepares a permit-ready package that shows charger count, equipment locations, panel work, and any trenching or pad work. The utility conversation starts early, because the project may need interconnection approval, service upgrades, or make-ready coordination before anyone can energize the system. If the owner waits until the permit is approved to open the utility file, the job usually sits idle.
Build the permit set around the electrical scope
Commercial electrical permits usually need enough detail for the plan checker to understand load, wiring method, equipment placement, and the code path. That means the drawings have to match field conditions, not a generic site sketch. I have seen projects sent back because the charger locations did not reflect the actual parking layout or because the panel schedule did not match the existing gear.
Utility timing needs the same discipline. Early utility engagement helps confirm whether the site can support the planned load and what upgrades may be needed before the owner commits to a location. That matters because the utility may not be able to support the load on the timeline the owner expects.
The code side also has to be clean from the start. For a practical overview of site requirements, plan checks, and the details that usually come up before field work starts, see our EV charger installation requirements guide.
Use incentives as support, not a substitute for planning
Incentive programs can improve the economics, but they do not remove the need for a solid site plan. The International Energy Agency reported that more than 1.3 million public charging points were added globally in 2024, an increase of more than 30% from the prior year, and projected under its STEPS scenario that about 150 million charging points will be added from 2025 to 2030, with around 8% of those being public charging points IEA EV charging outlook. That scale tells property managers the market is moving, but the site still has to be engineered correctly.
In the U.S., the cleanest path is usually to line up the permit scope, utility process, and funding strategy at the same time. Keep one person responsible for each lane, because permits, utility correspondence, and incentive paperwork all stall when everyone assumes someone else is handling them. If the project is eligible for a make-ready or rebate program, document every submittal and approval so the construction schedule does not drift while paperwork is pending.
Program rules can change the cost of a project, especially if they require specific equipment, utility paperwork, or installation sequencing. Incentives are useful when they fit the site and the timeline. They are not a fix for undersized service, bad drawings, or a utility queue that was ignored until construction was ready to start.
Understanding Total Installation Costs and Budget Planning
The biggest budgeting mistake is treating the charger price as the project price. In commercial EV charging station installation, the equipment is often only one line item, and the infrastructure work can change the total far more than the owner expects. A clean wall-mounted Level 2 job in a garage and a utility-heavy DC fast project in an outdoor lot are not even close to the same budget category.
Budget for the whole job, not just the hardware
The cost stack usually includes equipment, conduit and wiring, panel or switchgear work, trenching or core drilling, civil restoration, engineering, permitting, and project management. Then there are operational costs after startup, such as network subscriptions, billing platform fees, and any load-related utility charges that show up later. If the site needs a service upgrade, the budget should reflect that before a bid is accepted.
The table below gives owners a clean way to organize the estimate before bids come in.
| Component | Level 2 Installation | DC Fast Charging |
|---|---|---|
| Equipment | Lower | Higher |
| Electrical infrastructure | Often moderate, site-dependent | Often substantial, site-dependent |
| Civil work | Usually limited to moderate | Can be significant |
| Permitting and engineering | Required | Required |
| Ongoing network costs | Common | Common |
Watch the hidden costs that surprise owners
The expenses that catch managers off guard are usually the ones tied to the site itself. Parking reconfiguration can consume time and money, especially if accessible stalls, wheel stops, striping, or circulation patterns need to change. Utility-driven work can also push the budget far past the original guess, especially when the site's available capacity is tighter than expected.
A practical internal resource for budgeting conversations is this EV charger installation price guide, because it helps frame the cost questions owners should ask before they compare proposals. I also tell clients to ask every bidder to separate “equipment,” “electrical,” and “civil” into distinct buckets so they can see where the money is going.
If a proposal lumps everything into one number, it's harder to see whether the project is underpriced, incomplete, or both.
For Orange County properties, I've found that the cleanest budgets are the ones with a contingency mindset. The owner doesn't need a false promise, they need a scope that reflects the site's actual constraints and a contractor who can explain the assumptions line by line.
Selecting the Right EV Charging Contractor
A good contractor doesn't just hang equipment on a wall. The right team understands utility coordination, local inspection requirements, electrical service limits, and how to keep a commercial property operating while the work is underway. That matters because a charger project touches parking, power distribution, and tenant access at the same time.

Qualify the contractor like an electrical project, not a sales pitch
A California C-10 electrical license is the baseline, not the badge of excellence. The more important question is whether the contractor has managed commercial charging work, utility communication, and inspection closeout on occupied properties. Ask who handled the interconnection paperwork, who coordinated with the utility, and who has dealt with panel upgrades or load management in similar sites.
You should also ask for completed project photos, redacted permit sets, and reference calls from property managers rather than just equipment vendors. A contractor who can explain load calculations, conduit routing, and accessible stall placement in plain English is usually easier to work with than one who talks only in product names. For a company like Access Electrical and Lighting, EV charging station installation sits alongside broader commercial electrical and lighting work, which is useful when a project also needs panel service, parking lot lighting coordination, or low-voltage integration.
Red flags that deserve immediate attention
- Unclear scope: If the bid doesn't distinguish permitting, electrical work, and civil work, the owner is likely to find change orders later.
- Weak utility experience: If the team can't explain the interconnection path, the project can get stuck before energization.
- No inspection plan: If nobody knows who will schedule and attend the final inspection, the closeout will drag.
- Thin local knowledge: If the contractor doesn't understand the authority having jurisdiction, the drawings may not survive plan check.
One more thing matters, and it's easy to miss. A contractor who asks about current load, future expansion, and parking turnover is thinking like an installer, not just a bidder. That's the team I trust on occupied commercial sites.
Managing the Installation Timeline and Project Execution
A standard commercial charging project doesn't fail all at once. It slips in small pieces, a delayed submittal here, an equipment lead time there, then a utility question that sits unanswered for a week. On the best jobs, the contractor and property manager keep every moving part visible so the schedule doesn't drift.

A realistic sequence keeps the job moving

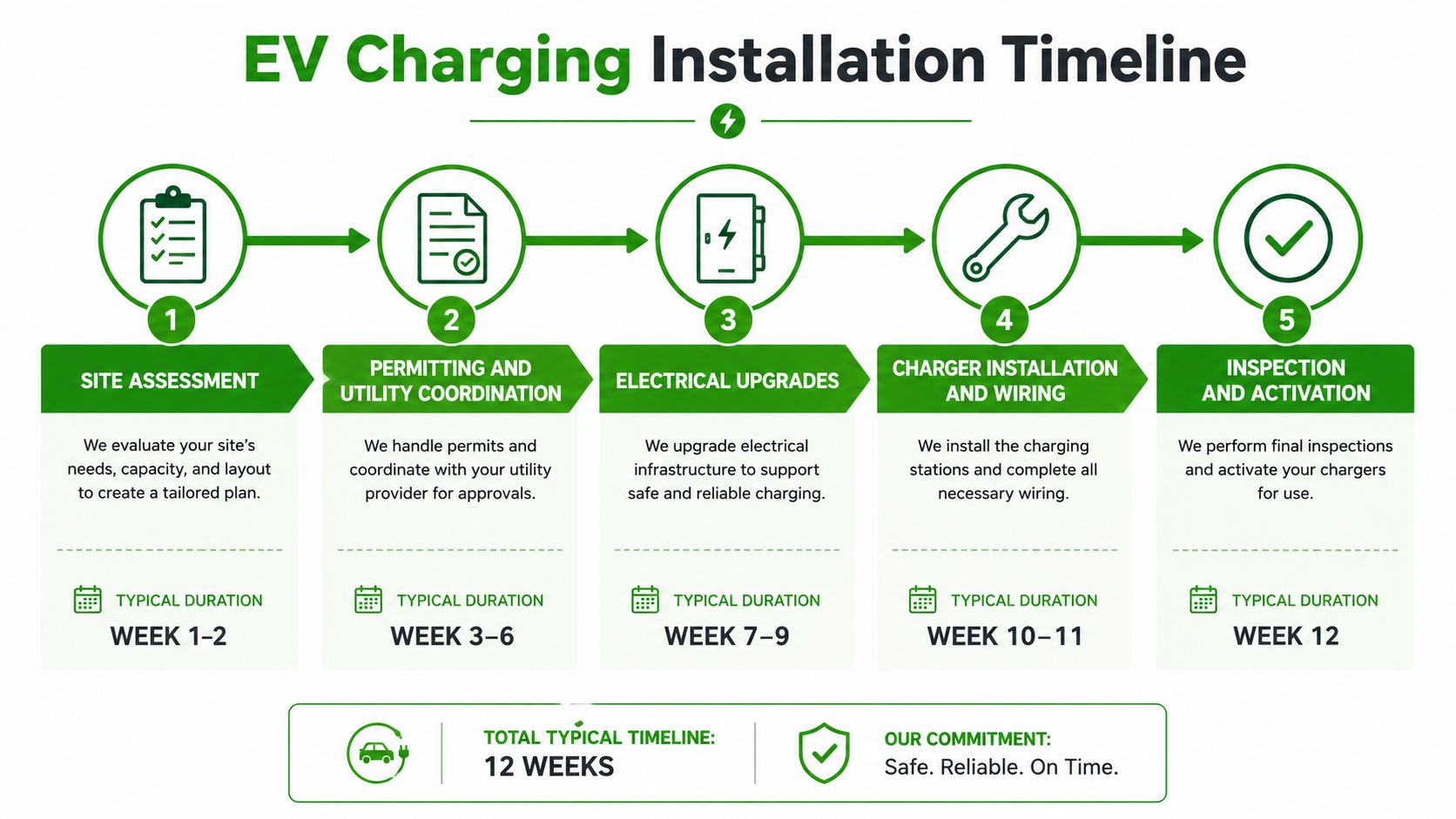

The work usually starts with site assessment and design development, then moves into permitting and utility coordination, followed by electrical construction, charger setting, wiring, inspection, and energization. On straightforward commercial sites, that flow often lands in a 12-to-16-week window, but only when the permit path is clear and the utility doesn't require major service work. If the project needs deeper electrical upgrades or more complex coordination, the schedule stretches quickly.
The fastest way to protect the timeline is to lock the design before ordering equipment. A lot of missed dates come from changing the charger count, moving the stalls, or discovering after procurement that the electrical room needs a different routing plan. Every one of those changes can force rework.
Keep the trade coordination tight
Electrical contractors, civil crews, and the utility all need different information at different times. The owner should insist on a single project lead who tracks submittals, inspection readiness, and field changes, because jobs stall when everyone is waiting on everyone else. If trenching or restoration is involved, the sequence matters even more, since the charger install can't close out until the site is back in usable condition.
The cleanest schedules come from owners who ask for weekly status, not owners who wait for the final inspection to ask what happened.
I've found that the projects that finish on time usually have one thing in common, the contractor plans around the utility and inspection calendar instead of assuming those dates will cooperate. That doesn't eliminate risk, but it keeps the project honest.
Ongoing Maintenance, Billing, and Energy Management
Once the chargers are live, the job shifts from installation to operations. Commercial EV charging station installation only pays off when the owner keeps the equipment reliable, the billing system understandable, and the load under control. A station that's down, confusing to use, or expensive to run doesn't stay popular for long.
Keep the equipment healthy
Preventive maintenance should include visual checks, connector inspection, cable condition, software updates, and confirmation that payment and access controls are still working. Networked chargers also need firmware attention, because the platform side often matters as much as the electrical side. If the property ignores updates, it can end up with chargers that are technically installed but operationally behind the curve.
Billing works best when it's easy for users and transparent for accounting. Some properties recover cost through per-kWh pricing, some use membership or tenant-based access, and some combine promotional pricing with staff-managed rules. The right model depends on whether the chargers are serving residents, employees, customers, or fleet vehicles.
Manage the load like a utility asset
Energy management matters because a commercial property usually can't treat chargers like isolated devices. Load management can stagger charging demand, protect the service capacity, and make phased expansion more realistic. If the site has solar or battery storage, those resources can also support the charging plan, but only if the control strategy is designed around how the property operates.
For owners looking at a contractor that can handle the broader electrical side, including EV charger work, Access Electrical and Lighting provides commercial electrical and lighting services along with EV charging station installation for Southern California properties. That matters on mixed-scope jobs where the parking lot, service gear, and support systems need one coordinated team.
Reliability isn't a one-time milestone, it's the result of maintenance, monitoring, and a billing setup that doesn't confuse the people using the chargers.
If you're planning a commercial EV charging project in Orange County or the surrounding Southern California market, talk with a contractor who can evaluate your service capacity, utility path, and parking layout before you buy hardware. Access Electrical and Lighting can help you assess the site, coordinate the electrical scope, and build an installation plan that fits the property instead of fighting it.
